Understanding Mat Foundations

When Does a Building Need a Mat Foundation Instead of Individual Footings?

A mat foundation — also called a raft slab — becomes the right choice when the structural engineer reaches a crossover point where individual spread footings no longer make practical or economic sense. That crossover happens when column loads are heavy enough that individual footings would need to be 8 feet square or larger, or when adjacent footings would overlap each other at the required bearing dimensions. Instead of pouring dozens of oversized individual pads, a single continuous slab covers the entire building footprint and distributes the total structural load across the maximum possible area. The bearing pressure on the soil drops to the average building weight per square foot — often 60 to 80 percent lower than what individual footings would impose at their edges.

In the Kansas City metro, three soil conditions push projects toward mat foundations more often than in other markets. First, alluvial deposits along the Missouri and Kansas river corridors carry inconsistent bearing capacity — sand and silt layers that may support 2,500 psf in one boring and 1,200 psf in the next boring 40 feet away. Individual footings on these sites settle at different rates, creating the differential movement that cracks structural frames and damages finishes. A mat foundation rides over these variations, averaging the bearing across the entire footprint and controlling differential settlement through the rigidity of the slab itself.

Second, old uncontrolled fill sites in the East Bottoms, West Bottoms, and Fairfax industrial districts present fill material of unknown origin placed decades ago without compaction documentation. Building on uncontrolled fill with individual footings is a recipe for failure — each footing finds a different density and composition beneath it. A mat foundation, combined with deep over-excavation and structural fill replacement, provides uniform support across the footprint. Third, heavily loaded industrial buildings — distribution centers with high-density racking, manufacturing facilities with concentrated equipment loads — generate column loads that push spread footings beyond practical dimensions on KC’s moderate-bearing clay soils. The mat is not just the safer choice; it is frequently the more economical one when the alternative is 30 or 40 oversized individual footings with extensive over-excavation at each location.

Large mat foundation reinforcement grid with two-way rebar mats on a Kansas City river valley construction site
KC Soil Conditions

Why Are Mat Foundations Common on KC River Valley and Fill Sites?

The Missouri and Kansas river corridors that define the KC metro create some of the most variable soil conditions in the Midwest. Alluvial sand and silt deposits shift in bearing capacity across short distances — a boring at one corner of the building may show 2,500 psf while the opposite corner reads 1,200 psf. Individual spread footings on this soil settle at different rates. One column drops a quarter inch while its neighbor drops three-quarters. That half-inch differential propagates upward through the steel frame, cracking finishes, binding doors, and racking equipment.

Old industrial fill sites compound the problem. Decades of uncontrolled fill placement without compaction documentation means the material beneath the building is unknown in composition, density, and depth. A mat foundation — combined with deep over-excavation and engineered structural fill — eliminates the uncertainty. The rigid slab bridges over minor soil inconsistencies, and the uniform subgrade preparation ensures the bearing surface beneath the mat is consistent from edge to edge.

24–48″
Typical Thickness
5,000+ PSI
Concrete Strength
Two-Way
Rebar Mats

Planning a Heavy Industrial or Warehouse Foundation?

Talk to our mat slab specialists. Send your structural drawings and geotech report for a detailed bid.

Call (816) 339-8133
Structural Engineering

What Engineering Goes Into a Kansas City Mat Foundation?

Mat foundation design is driven by three structural calculations that determine the slab thickness, reinforcement, and concrete specification. Punching shear at column locations is the primary failure mode — the column load tries to punch through the mat like a finger through drywall. The structural engineer calculates the shear stress around each column perimeter and sizes the mat thickness to keep that stress below the concrete's shear capacity, or adds headed shear studs to reinforce the critical perimeter. On heavily loaded columns — 200,000 to 500,000 pounds in a warehouse or industrial building — punching shear often governs the mat thickness at 36 to 48 inches.

Bending moments between columns create the second design requirement. Upward soil pressure between columns bends the mat upward (positive moment), while the concentrated column loads bend it downward at the column locations (negative moment). Two-way reinforcing steel — top and bottom mats of number 6 to number 9 bars at 6 to 12 inch spacing in both directions — resists these opposing bending forces. The bottom mat handles the positive moment; the top mat handles the negative moment. Additional reinforcing at column locations supplements the punching shear resistance.

Thermal cracking prevention is the third critical engineering concern on any mat over 30 inches thick. Cement hydration generates heat — in a 36-inch mat, the core temperature can exceed 150 degrees Fahrenheit while the surface cools toward ambient. If the differential exceeds 35 degrees Fahrenheit, thermal cracks propagate from the surface inward. The pour plan must address thermal control: low-heat mix designs with fly ash or slag cement replacement to reduce peak temperature, placement during cooler hours in KC summers, insulated blankets to control cooling rate, and embedded thermocouples for real-time temperature monitoring throughout the 5 to 7 day curing period. Kansas City Concrete Contractors includes a thermal management plan as a standard deliverable on every mat foundation project.

Mass pour logistics complete the engineering challenge. A 10,000 square foot mat at 30 inches thick requires approximately 400 cubic yards of concrete — 40 to 50 ready-mix trucks placed in a single continuous operation. The pour cannot stop. A cold joint in a mat foundation compromises the structural integrity of the entire slab. We coordinate the ready-mix supply chain, boom pump positioning, crew staging, and backup equipment before concrete day, building redundancy into every element of the operation.

Mat Foundation Specs — KC Metro
Typical Thickness
Range: 24–48 inches
Concrete Strength
Specification: 5,000–6,000 PSI
Rebar Configuration
Layout: #6–#9 bars, 6–12″ O.C., both ways, top & bottom
Pour Rate
Delivery: 1 truck every 8–12 minutes
Thermal Control
Max differential: 35°F core-to-surface
Application

Warehouse & Industrial

Heavy racking loads, forklift traffic, and concentrated column loads push individual footings beyond practical dimensions. Mat foundations distribute these loads across the full footprint while providing the flat, level surface that high-bay racking systems demand.

Application

Multi-Story Structures

Three to five story buildings with closely spaced columns generate cumulative loads that would require overlapping footings on KC clay. A mat foundation handles the combined loading while controlling the differential settlement that damages upper-floor finishes and mechanical systems.

Application

River Valley Sites

Alluvial sand and silt along the Missouri and Kansas rivers carry variable bearing capacity across short distances. Mat foundations average the bearing across the full footprint, controlling differential settlement that individual footings on these soils cannot prevent.

The Process

How Is a Mat Foundation Poured From Start to Finish?

Six phases from geotechnical analysis through final cure. Every phase verified before advancing to the next.

01

Geotech Analysis & Mat Design

Review geotechnical boring logs, soil classification, and allowable bearing pressures.

Coordinate with the structural engineer on mat thickness, reinforcement schedule, and punching shear design at column locations. Identify KC-specific risks: alluvial variability near river corridors, old uncontrolled fill requiring removal, and Wymore clay moisture sensitivity that affects subgrade preparation.

02

Mass Excavation & Soil Prep

Excavate to design subgrade elevation across the full building footprint.

Over-excavate unsuitable native soil — typically 24 to 48 inches on alluvial and fill sites — and replace with compacted structural fill. Every lift placed in 8-inch layers, moisture-conditioned, and compacted to 95 percent modified proctor with nuclear density gauge verification at depth. The subgrade beneath a mat foundation must be uniform across the entire footprint — any soft pocket creates a stress concentration in the slab above.

03

Two-Way Rebar Placement

Install bottom mat reinforcement first — typically number 6 to number 9 bars at 6 to 12 inch spacing in both directions, supported on heavy-duty bar chairs rated for the concrete head pressure of a 24 to 48 inch slab.

Place top mat reinforcement on supports maintaining the design clear spacing between layers. Add punching shear reinforcement at column locations — headed studs or additional bars per the structural design. A 10,000 square foot mat may require 40 to 60 tons of reinforcing steel placed over 3 to 5 days.

Critical Path Operation
04

Pour Logistics & Staging

Coordinate the ready-mix supply chain before concrete day.

A 400 cubic yard mat requires 40 to 50 truck loads on a staggered 8 to 12 minute delivery schedule to maintain continuous supply at the pump. Position boom pump for maximum reach coverage. Stage two finishing crews, internal vibrators, and backup equipment. Verify concrete mix design — 5,000 to 6,000 psi with controlled heat of hydration for mass placement. Hot weather pours use ice or chilled water; cold weather pours use heated water and accelerator.

05

Continuous Placement & Finishing

Place concrete in systematic strips advancing across the footprint, maintaining a live edge on previously placed concrete to eliminate cold joints.

Internal vibrators consolidate every lift to remove voids and honeycombing around the dense rebar grid. Finishing crews follow the placement crew, striking off and bull-floating each section while the concrete is still workable. On a 400 cubic yard mat, the pour may run 8 to 12 hours with no stops. This is the operation where experience matters most — timing, crew coordination, and concrete supply chain management determine whether the mat is poured as one monolithic slab or compromised by cold joints.

06

Thermal Monitoring & Curing

On mats over 30 inches thick, install embedded thermocouples at the core and surface before the pour.

Monitor the temperature differential between core and surface continuously for 5 to 7 days — keeping the differential below 35 degrees Fahrenheit to prevent thermal cracking. Apply insulated blankets immediately after finishing: in winter to slow surface cooling, in summer removed gradually over 3 to 5 days to prevent thermal shock. Wet cure critical areas for 7 days. Pull break test cylinders at 7 and 28 days to verify specified compressive strength.

Mass Pour Expertise

How Do You Prevent Thermal Cracking in a Thick Mat Foundation?

Cement hydration is exothermic — the chemical reaction that hardens concrete generates heat. In a 4-inch sidewalk, that heat dissipates harmlessly. In a 36-inch mat foundation, the interior temperature can exceed 150 degrees Fahrenheit while the surface cools toward ambient temperature. The trapped heat creates a temperature gradient between the core and the surface. When that differential exceeds 35 degrees Fahrenheit, the surface contracts while the interior remains expanded, generating tensile stresses that crack the concrete from the outside in.

Thermal cracking prevention starts with the mix design. Replacing 25 to 40 percent of Portland cement with fly ash or slag cement reduces the peak hydration temperature by 15 to 25 percent without sacrificing the 28-day compressive strength the structural engineer specified. Placement timing matters — pouring during cooler evening hours in KC summers limits the initial concrete temperature to 85 degrees or less.

After placement, insulated blankets are the primary tool. In winter, they slow surface cooling to keep the differential below 35 degrees. In summer, they are removed gradually over 3 to 5 days to prevent thermal shock from a sudden temperature drop at the surface. Embedded thermocouples at the core and surface provide real-time temperature data throughout the curing period — typically 5 to 7 days on mats over 30 inches thick. Our crew monitors the readings and adjusts blanket coverage as needed to maintain the gradient within safe limits.

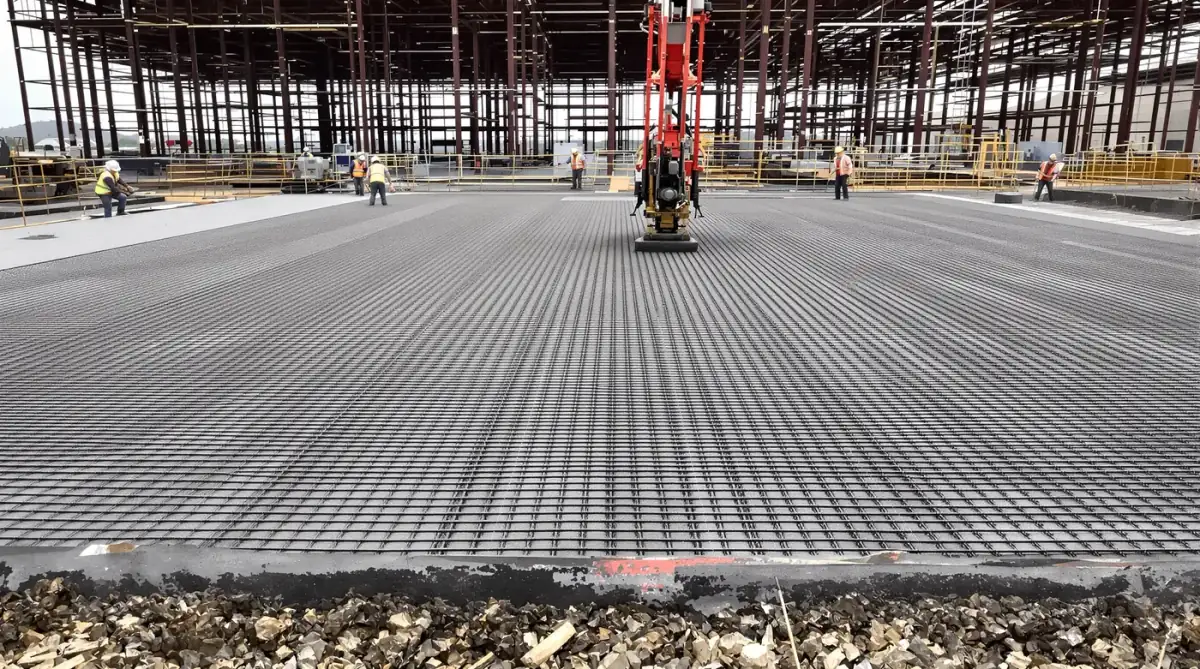

Insulated curing blankets on a thick mat foundation pour with thermocouple monitoring in Kansas City
400+
CY Single Pours
11+
Years Serving KC
MO·KS
Two-State Licensed
Boom Pump
Placement
Cost Overview

Mat Foundation Cost Ranges in Kansas City

Component Typical Range Notes
Mat foundation (complete, in place) $12 – $25 / SF Thickness and rebar density dependent
Over-excavation & structural fill $15 – $30 / CY Depth and haul distance dependent
Reinforcing steel (placed and tied) $1.20 – $1.80 / lb 40-60 tons typical on 10,000 SF mat
Concrete (5,000+ psi, pumped) $180 – $240 / CY Includes pump and placement
Thermal monitoring (mass pour) $2,000 – $5,000 Thermocouple install and monitoring

Mat foundation pricing varies significantly based on slab thickness, reinforcement density, soil conditions, and pour volume. A 10,000 square foot mat at 30 inches thick typically runs $120,000 to $250,000 in the Kansas City metro. The higher end of the range applies to heavily reinforced mats on sites requiring deep over-excavation and structural fill. Call (816) 339-8133 with your structural drawings and geotech report for a detailed, line-item bid.

Mat Foundation FAQ

Questions About Mat & Raft Slab Foundations in Kansas City

When is a mat foundation the right choice in Kansas City?
Mat foundations make sense when individual spread footings would overlap each other due to high column loads or low soil bearing capacity, when the building sits on alluvial deposits near the Missouri or Kansas rivers where bearing is inconsistent, on sites with old uncontrolled fill where differential settlement is a concern, or when the building includes a full basement where the mat doubles as the basement floor slab. In the KC metro, roughly 30 percent of commercial foundation projects use mat foundations — most commonly on industrial and heavy commercial structures near the river corridors.
How thick is a typical commercial mat foundation?
Mat foundation thickness in the Kansas City area typically ranges from 24 to 48 inches depending on column loads, column spacing, and soil bearing capacity. Heavily loaded industrial buildings may require mats 36 to 48 inches thick with top and bottom reinforcing mats. Lighter commercial structures on moderate soils may use 24 to 30 inch mats. The structural engineer determines the thickness based on punching shear at columns, bending between columns, and overall settlement calculations from the geotechnical report.
How is a mat foundation reinforced?
Mat foundations carry two-way reinforcing steel mats in both the top and bottom of the slab. The bottom mat resists upward bending between columns where soil pressure pushes up. The top mat resists downward bending at column locations where concentrated loads push down. Typical reinforcement includes number 6 to number 9 bars at 6 to 12 inch spacing in both directions, with additional reinforcing at column locations to resist punching shear. The clear spacing between top and bottom mats must be maintained with chairs and supports throughout the pour.
How do you pour a mat foundation without cold joints?
Mat foundations require continuous concrete placement across the entire footprint to avoid cold joints that weaken the slab. We coordinate multiple ready-mix trucks in a staggered delivery schedule to maintain a constant supply of concrete at the pump. Boom pumps allow us to reach all areas of the mat without moving equipment. Internal vibrators consolidate each lift before the next load arrives. On large mats, we divide the placement into systematic strips, advancing across the footprint while keeping a live edge on the previously placed concrete. Temperature and timing control are critical — especially in KC summers when hot concrete sets faster.
What does a mat foundation cost in Kansas City?
Mat foundation costs in the KC metro typically range from $12 to $25 per square foot installed, depending on thickness, reinforcement density, and site conditions. A 10,000 square foot mat at 30 inches thick runs roughly $120,000 to $250,000 including excavation, soil prep, rebar, concrete, and curing. The higher end of the range applies to heavily reinforced mats on sites requiring deep over-excavation and structural fill. Contact us at (816) 339-8133 with your structural drawings and geotech report for a detailed bid.
How do you prevent thermal cracking in thick mat foundations?
Thick mat foundations generate significant heat during cement hydration — the interior temperature can exceed 150 degrees Fahrenheit in mats over 36 inches thick. If the temperature differential between the interior and the surface exceeds 35 degrees, thermal cracking occurs. We prevent this by specifying low-heat mix designs with fly ash or slag cement replacement, placing concrete during cooler hours in summer, using insulated blankets to slow surface cooling in winter, and monitoring internal temperatures with embedded thermocouples on mass placements. The pour plan addresses thermal control as a critical path item.
